The Construction phase is when the groundwork—literally—begins! From site prep and laying the foundation to seeing real progress rise up, this is where big plans turn into exciting reality. We’ll be sharing weekly updates filled with photos and videos so you can follow along every step of the way. Check out our overview schedule below—or click on a date to explore photo updates and see the progress for yourself!
Public Safety Building
Project Overview
The City is building a brand-new Public Safety Building that will be home to both the Police Department and Municipal Court! It’s going up on the site of the former Norcross Library, right at the corner of Buford Highway and Stevens Road. We’ve got a powerhouse team bringing this project to life: CROFT & Associates designed the building, Turner & Townsend Heery/AEI is managing the project, and Reeves Young is leading the construction. Big things are happening—stay tuned!
Construction Phase
Norcross’s new Public Safety Building is quickly taking shape, bringing a modern, purpose-built facility for the Police Department and Municipal Court.

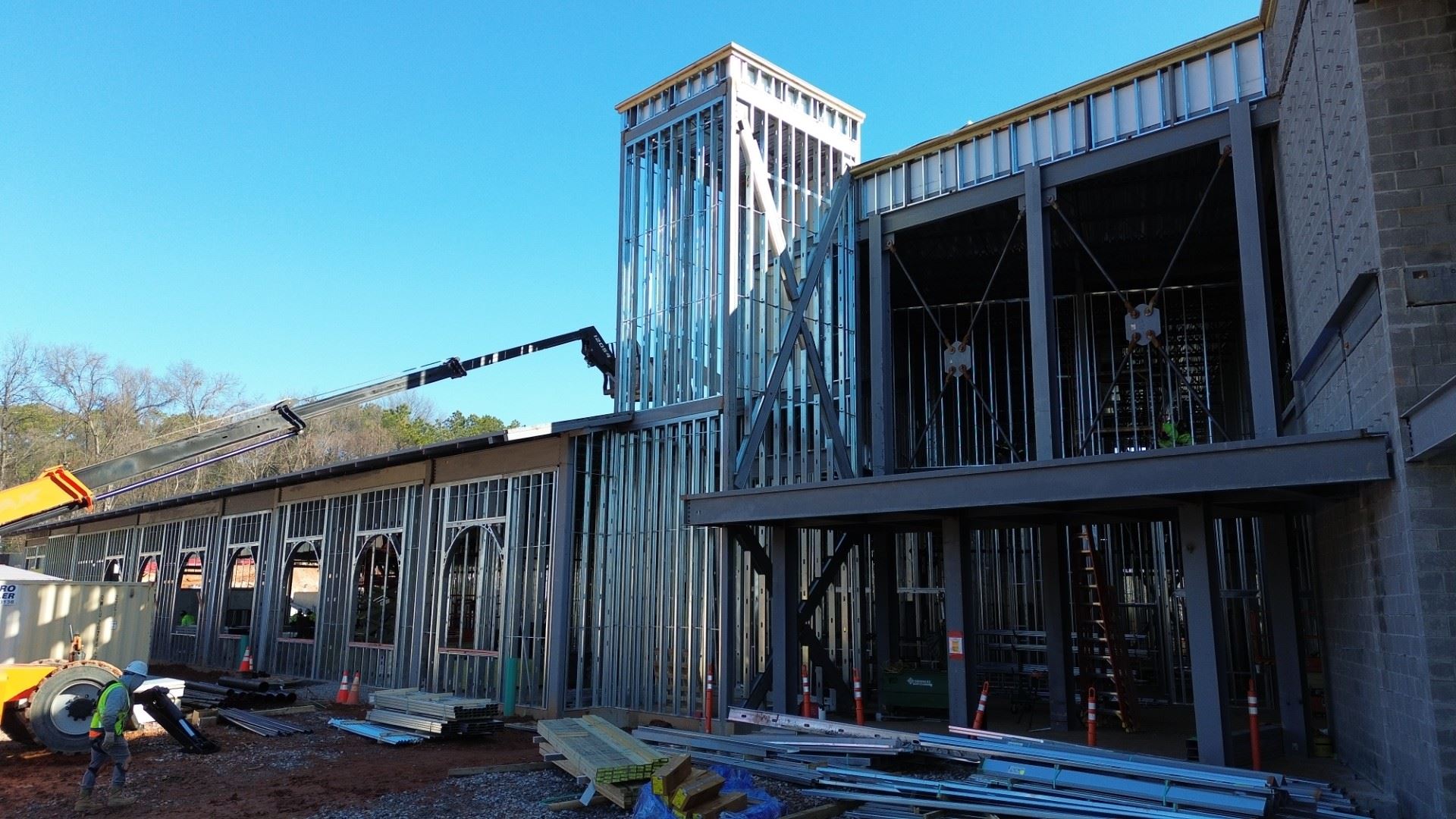

Rising on the site of the former Norcross Library at Buford Hwy. and Stevens Rd., the 42,252-square-foot facility is beginning to look like the architect’s original vision. Framing is nearly complete, exterior brickwork is underway along Buford Highway and windows are scheduled for installation. The project team expects the building to be “dried in” (weather-tight) within the next four weeks. Progress is also visible behind the building, where a portion of the secured rear parking lot has been paved.
When complete, the building will include approximately 2,600square feet of public-facing meeting space, along with more than 4,000 square feet of unfinished space reserved for future needs. The project remains on schedule formid-August completion.

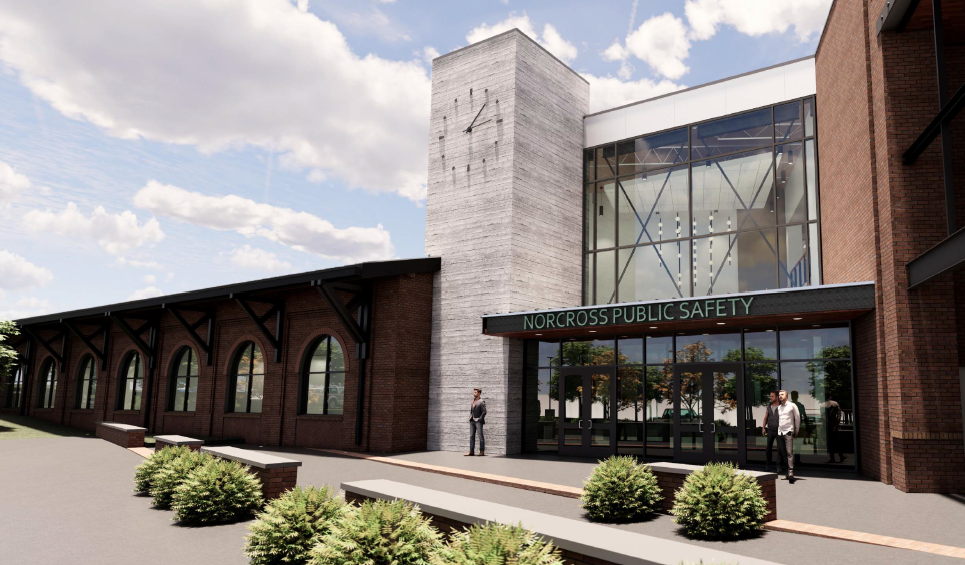

A great way to see how far we’ve come: check out the side-by-side images in this issue,an architect rendering from last year next to a recent photo taken from the same front entryview.
Follow along for continued updates, full project details and the construction schedule.Also, be sure to check out our YouTube Channel to watch the latest drone footage!
The next major milestone is expected in March, when the building is dried in with the roof, windows and exterior doors installed. Follow along for continued updates, full project details and the construction schedule.
Also, be sure to check out our YouTube Channel to watch the latest drone footage!

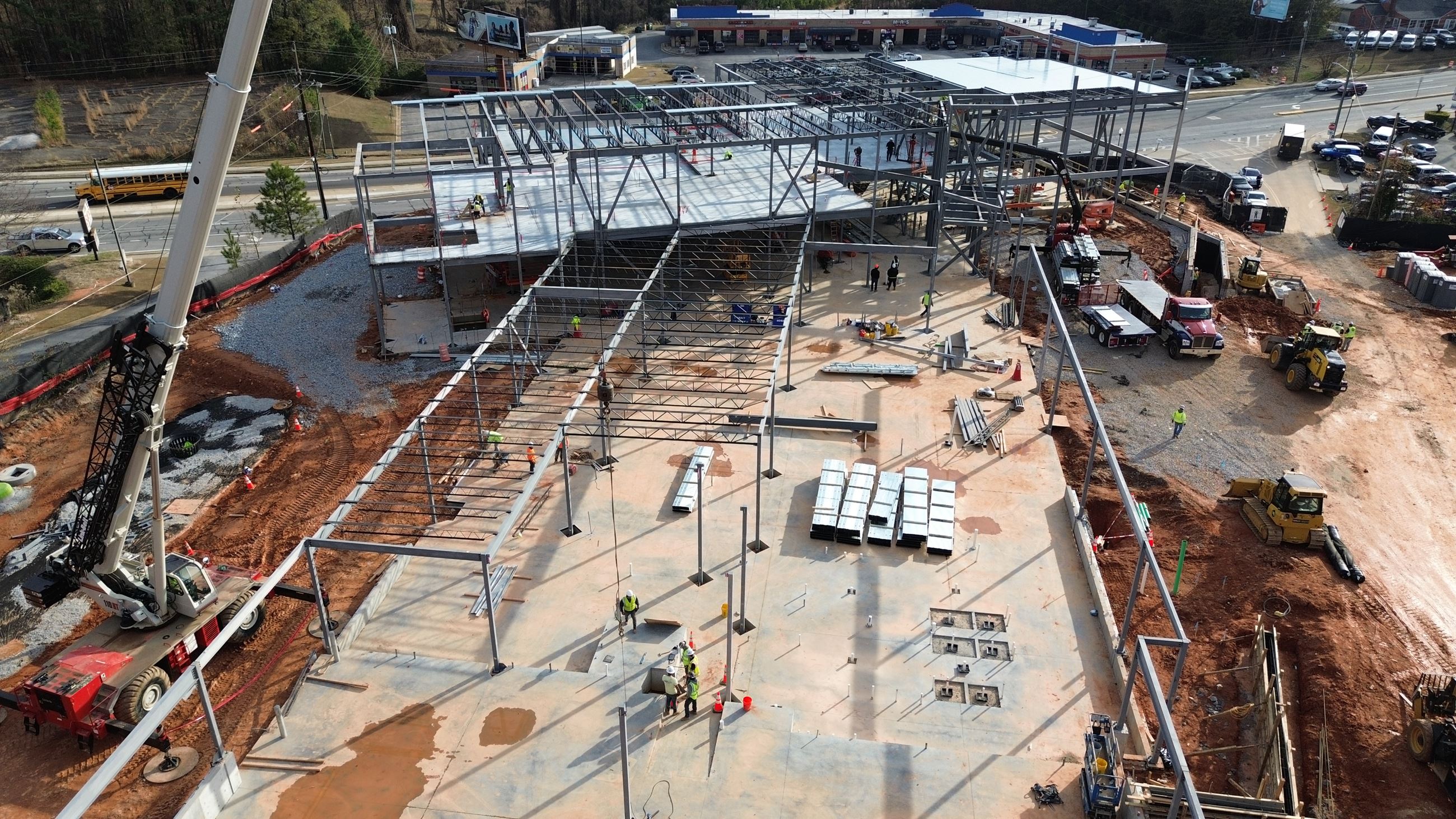

As of November 21, construction on the new Public Safety Building remains right on schedule. Structural steel framing is now underway, marking an exciting new phase as the building begins to take shape. Follow along for updates, discover full project details and the construction schedule.

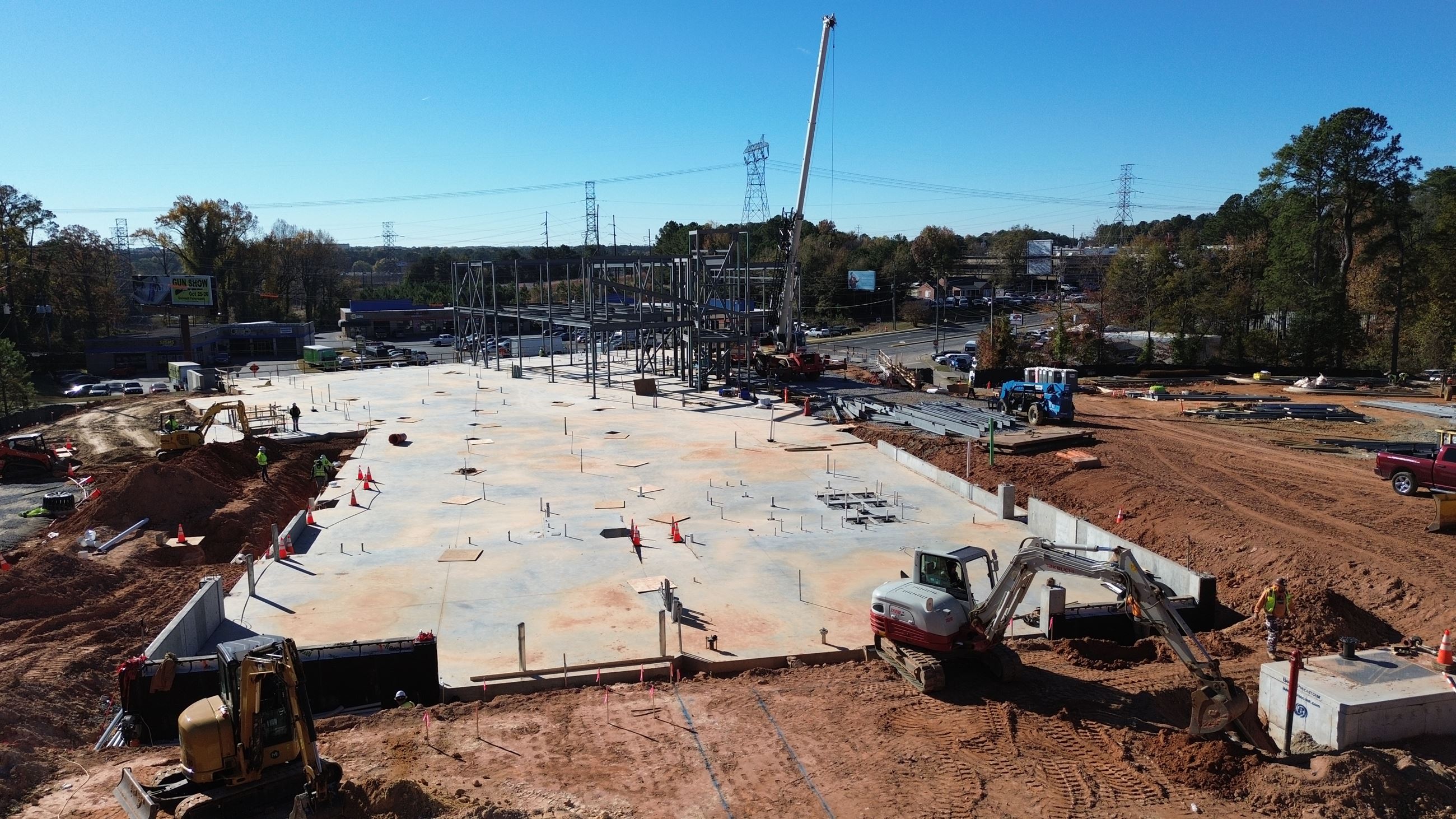

As of October 14, crews continue to make great progress on the new Public Safety Building! Foundation work is now about halfway complete, and the building’s slab will be poured in the coming weeks. Follow along for updates, discover full project details and the construction schedule.

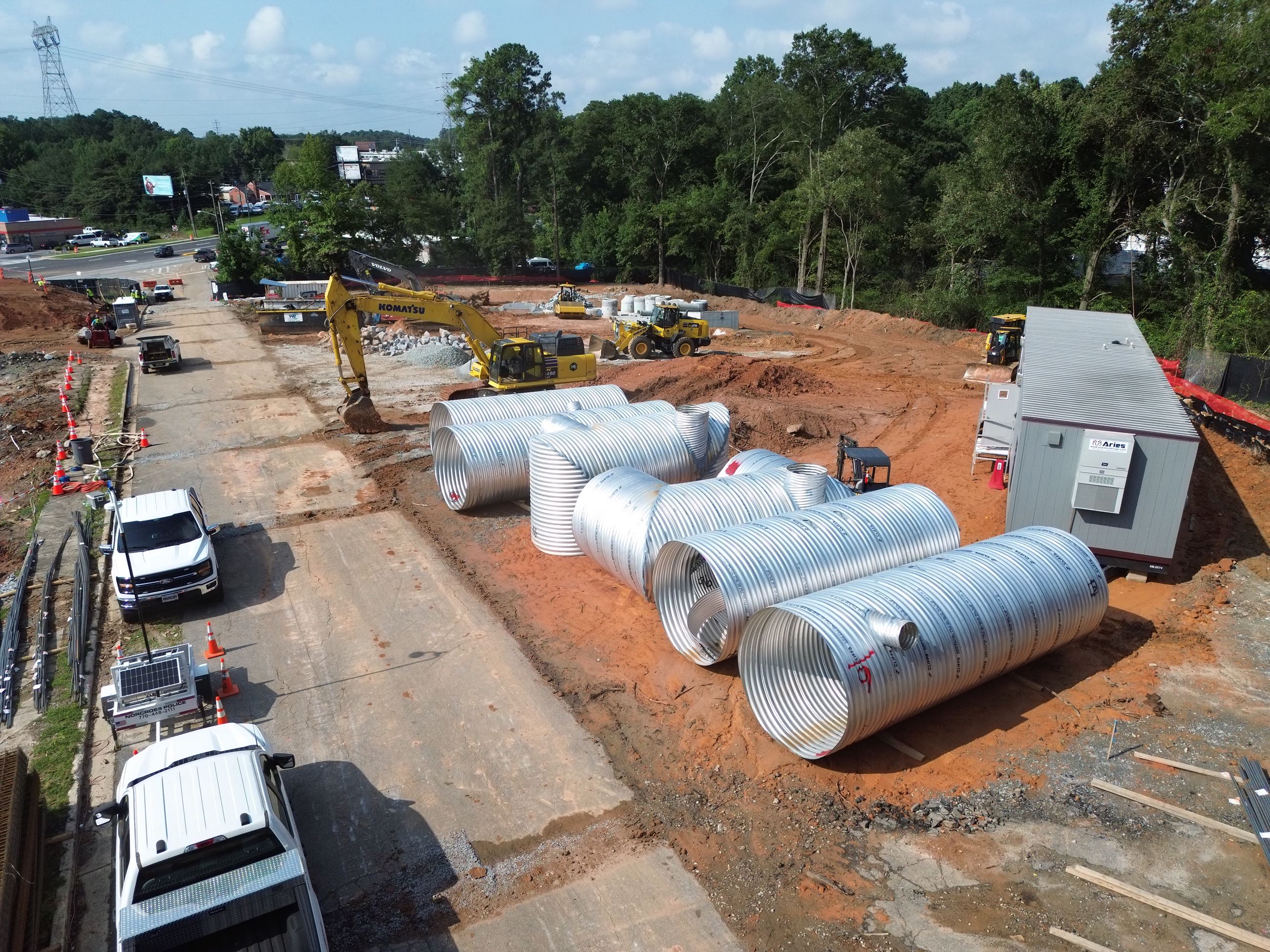

As of August 20, crews are making great progress on the new Public Safety Building! Large underground stormwater pipes are being installed to manage runoff, and heavy equipment is preparing the site for the foundation. Follow along each week for updates, and click the link below for full project details and the construction schedule.
Also, be sure to check out our YouTube Channel to watch the latest drone footage!

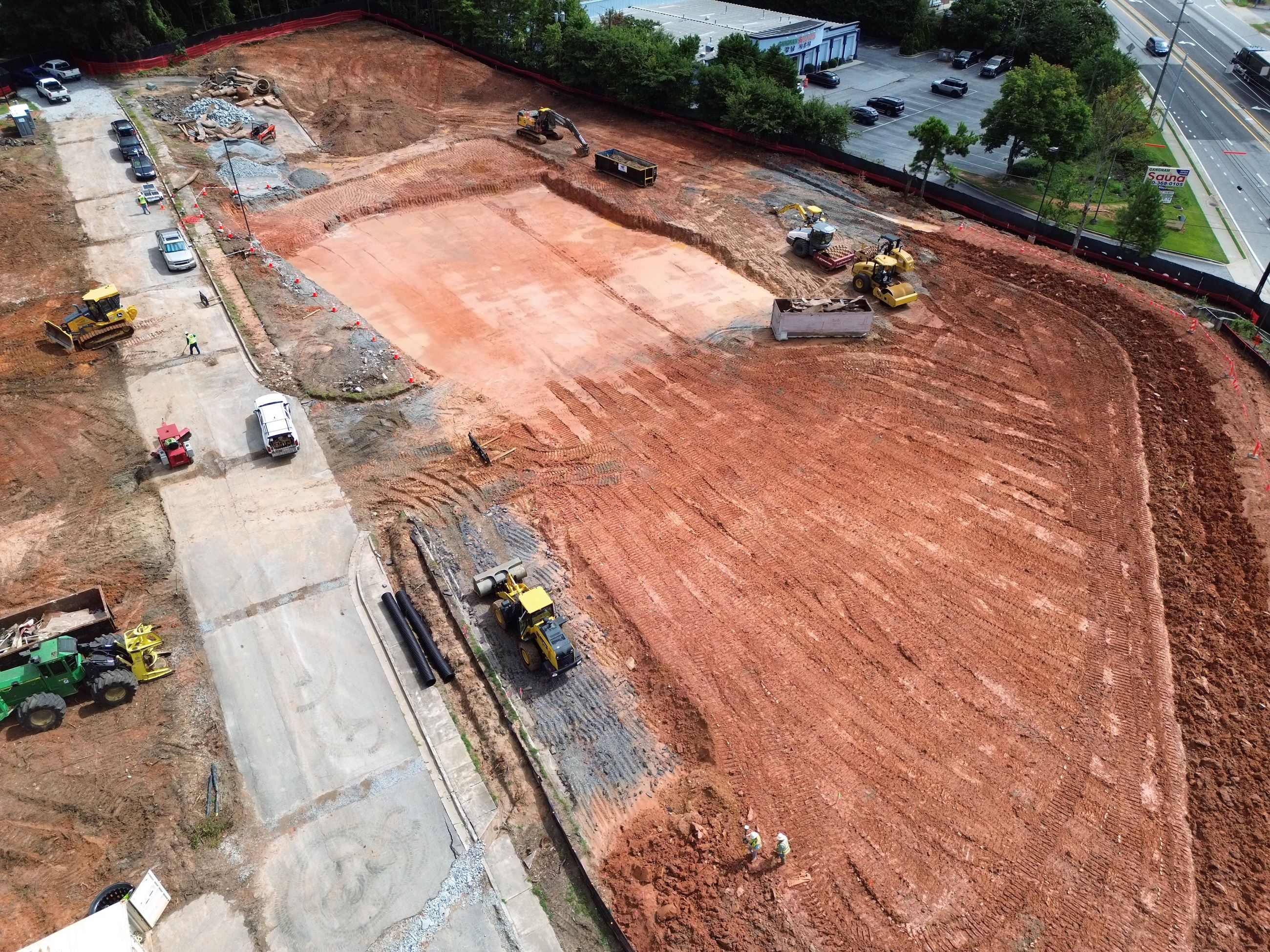

As of August 6, grading is well underway, and the building pad is taking shape as crews prepare for foundation work. Heavy equipment is on-site, leveling and compacting the ground to get ready for the next phase.
Also, be sure to check out our YouTube Channel to watch the latest drone footage!

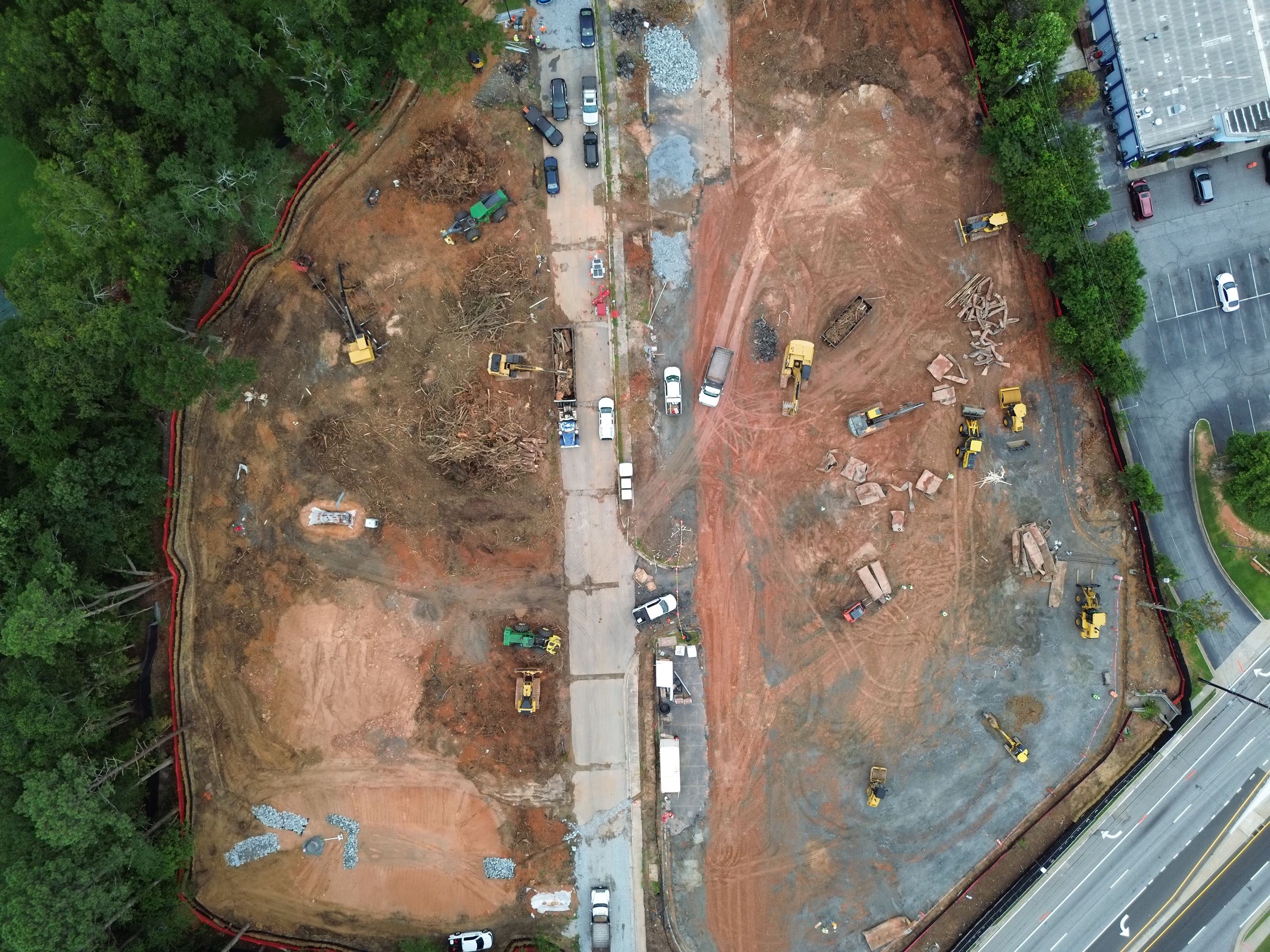

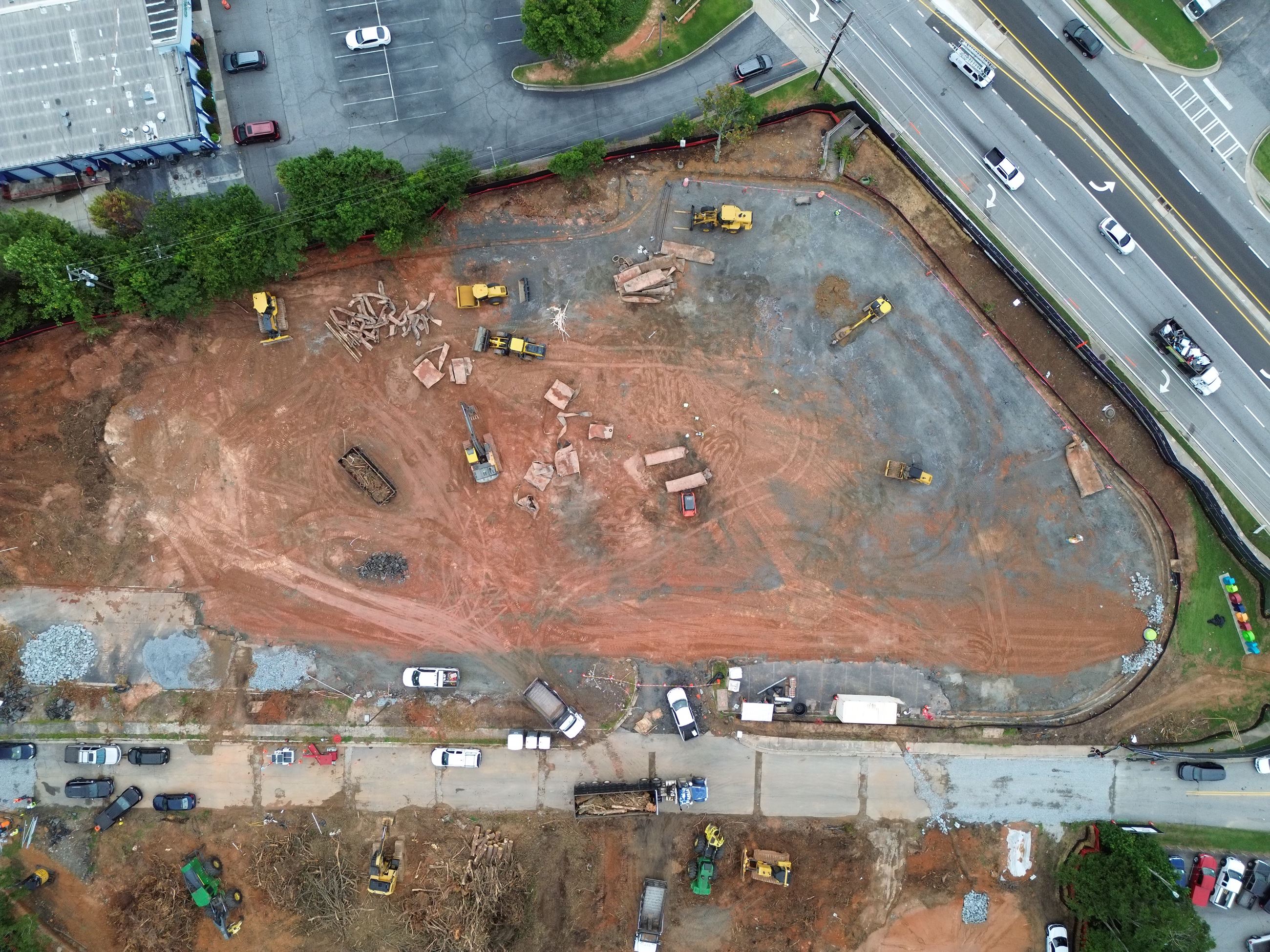

As of July 30, construction is underway at the Public Safety Building site following a successful start with land clearing and site prep on July 14. Foundation work is scheduled to begin next week, marking the next big step forward.
Also, be sure to check out our YouTube Channel to watch the latest drone footage!
Overview Schedule
July 14, 2025 – Construction officially begins
September 2025 – Grading and utility work completed
October 2025 – Concrete slab poured and completed
March 2026 – Roofing work completed
June 2026 – Interior work, parking lot, and landscaping completed
July 2026 – Final touch-ups and punch list items completed
August 11, 2026 – Target completion date
August-September 2026 – Move-in begins
